NEWS
Amazon’s Off-Grid Pecos Plant Is Sold as a Ratepayer Gift
Amazon’s Pecos campus starts off the Texas grid so family bills do not rise, while a 7.65 GW gas plant takes a record carbon permit and plans to interconnect later.

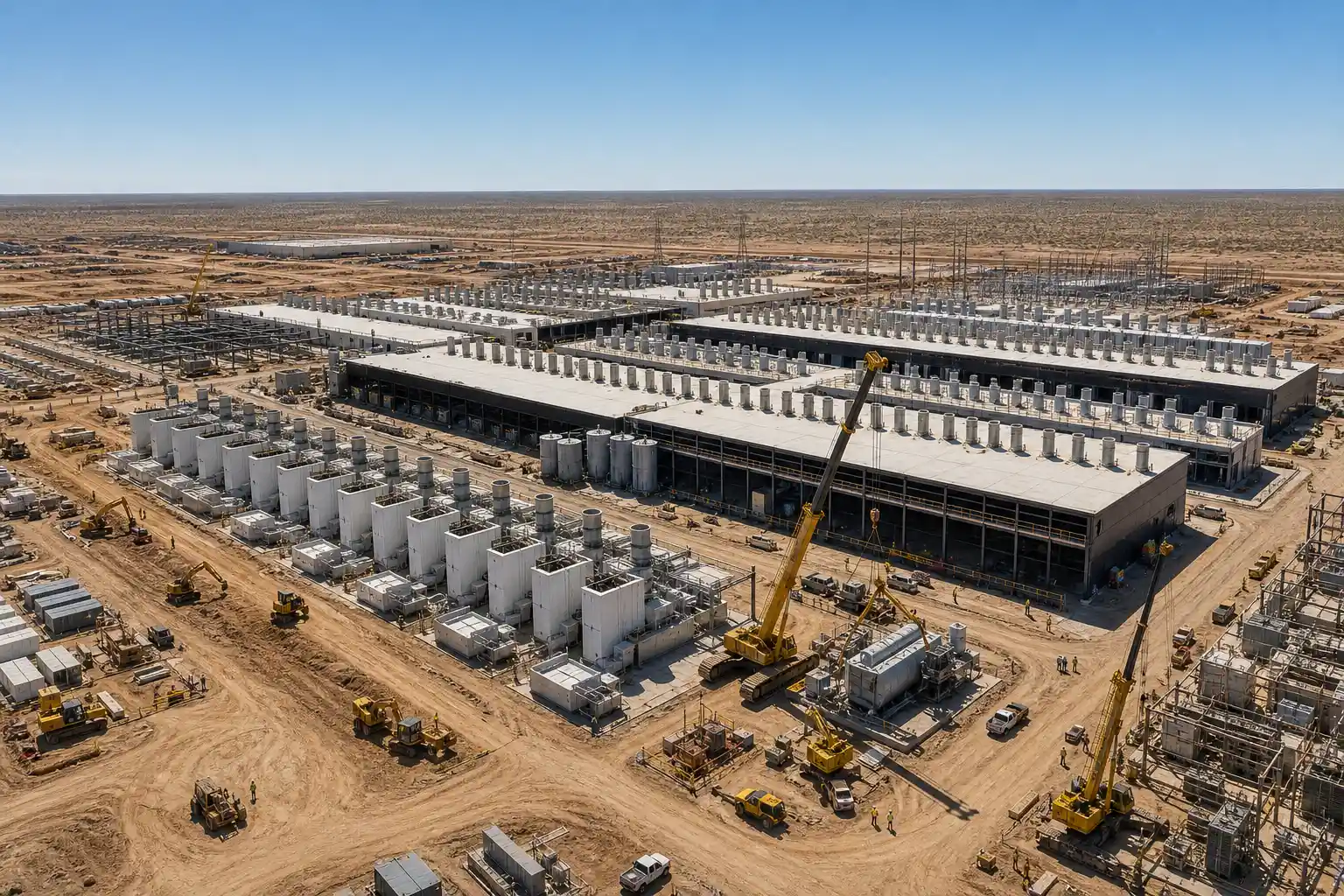

Amazon confirmed in August 2026 that it bought the GW Ranch site in Pecos County, Texas, for an AI campus fed by a 7.65 gigawatt gas plant. The campus would start off the Texas grid, a spokesperson said, so it will not raise electricity costs for Texas families. The same design skips the interconnection queue, carries a carbon permit larger than any working U.S. plant reports, and is already written to connect later.
Pacifico Owns the Plant, Amazon Buys the Power
The air permit is not in Amazon’s name. Texas Commission on Environmental Quality permit 181033, with federal companions PSDTX1672 and GHGPSDTX255, was issued on Jan. 21, 2026, to Pacifico GW, LLC, for the GW Ranch Energy Center at Fort Stockton, at latitude 31.171 and longitude -102.895. The authorization runs to Jan. 21, 2036. Construction that never starts within 18 months can void the file.
Pacifico Energy, founded in 2012 and based in San Juan Capistrano, California, said it has developed more than 1,750 megawatts of projects and will own and run the generation campus. Amazon confirmed to Cleanview, the energy-data firm that matched construction filings to satellite photos, that it acquired the site and will buy power from the plant. Land clearing was visible on July 24, 2026. In early August, Amazon filed three state construction permits for data-center buildings and said work would begin at once.
THE PAPER TRAIL TO AUGUST
- January 21, 2026: TCEQ issues the GW Ranch air permit to Pacifico GW, LLC.
- January 26, 2026: Pacifico announces the permit and a path to more than 5 gigawatts of delivered power.
- July 24, 2026: Satellite imagery shows land clearing on the Pecos County tract.
- August 7, 2026: Amazon confirms the land purchase and the power-purchase plan.
That split of roles is the legal heart of the campus. Pacifico holds the big air file. Amazon shows up as the customer and the builder of the halls. The data-center side can then sit behind a lighter air permit because the turbines are a different company on paper.
The Pitch That Will Not Raise Texas Family Bills
Amazon’s statement and Pacifico’s sales copy use the same sentence in different clothes. Both say new on-site power keeps household rates out of the story.
Amazon believes in paying the full costs of powering our operations. Our new planned data center campus in Pecos County does just that: it’s powered by new on-site generation that won’t raise electricity costs for Texas families and designed to transition to grid-connected service as interconnection timelines allow.
Amazon spokesperson, statement to Cleanview, August 2026
Pacifico CEO Nate Franklin tied the January permit to speed and certainty for large-load customers. Constantyn Gieskes, vice president of project development, said turbines were already secured and that customers would see power in 2027, with a path to more than 5 gigawatts. The company’s public project page goes further: the campus will operate independently from the electricity grid, and no new utility transmission lines will be required.
On Oct. 2, 2026, AWS chief executive Matt Garman repeated the household-bill line as company policy and said Amazon works with utilities and grid operators so the prices it pays cover energy and the wires, and so data centers do not raise electricity bills. In Pecos, the method is not a utility rate case. It is a private plant on the customer’s side of the meter, at least at the start.
A Permit Ceiling of 33 Million Tons
The January file allows the gas plant to emit 33 million tons of carbon dioxide a year. That number is a cap, not a forecast, and plants rarely run at the top of a permit. If this one did, it would outrank every U.S. facility that reports greenhouse gases today.
The EPA’s Greenhouse Gas Reporting Program for 2023 listed Alabama Power’s James H. Miller Jr. plant at almost 16.6 million tons, then the largest single source in the country. A full-use year at GW Ranch would be roughly twice that figure. The same EPA dataset treats power plants as the largest stationary source of reported U.S. greenhouse gases.
HOW THE TONNAGE STACKS UP
| Measure | Figure | What the figure is |
|---|---|---|
| GW Ranch CO2 authorization | 33 million tons a year | TCEQ permit ceiling, not a forecast |
| James H. Miller Jr. plant, 2023 | almost 16.6 million tons | EPA GHGRP, then the top U.S. facility |
| Amazon company footprint, 2025 | 80.85 million metric tons CO2e | Amazon sustainability report, all scopes |
| Amazon company footprint, 2024 | 69.55 million metric tons CO2e | Prior-year figure in the same report |
Amazon’s 2025 sustainability report put the company’s total at 80.85 million metric tons of carbon dioxide equivalent, up 16 percent from 69.55 million the year before. Electricity-related emissions rose 34 percent in that accounting, which the company tied to data-center growth. Amazon still points to The Climate Pledge, the 2019 vow of net-zero carbon emissions by 2040, and to a carbon-free portfolio it puts at 42 gigawatts across more than 712 projects in 30 countries. For Texas, it said it has enabled 10 gigawatts across 40 carbon-free projects. The Pecos turbines are not in that column.
Amazon also said the campus will use non-potable brackish groundwater, a source it described as unfit for drinking or irrigation. That answers the water fight that has followed data halls into other counties. It does not move the carbon cap.
Why the Campus Starts off the Texas Grid
ERCOT told the Texas Senate in July 2026 it was tracking about 474 gigawatts of large-load interconnection requests, about 90 percent of them data centers. Only a thin slice of that paper load is approved to energize. A behind-the-meter plant is how a campus gets steel in the ground while that queue sits.
Amazon’s own clause already treats isolation as temporary. The campus is “designed to transition to grid-connected service as interconnection timelines allow.” Pacifico’s FAQ still says the project does not draw from or add load to ERCOT and that no new utility lines will be needed. Those two sentences can both be true in 2027 and stop being true the year a switchyard opens.
WHAT WE KNOW
- The buyer: Amazon acquired the GW Ranch site and plans to buy power from Pacifico’s plant.
- The first mode: The campus is permitted and marketed to run as a private grid at the start.
- The later mode: Amazon’s statement already plans a grid hookup when interconnection timelines allow.
WHAT IS UNCONFIRMED
- Buildout: How much of the 7.65 gigawatt nameplate is actually installed, and on what years after 2031.
- Hookup date: When, or whether, ERCOT studies a connection large enough to matter.
- Running tons: What share of the 33 million ton ceiling the turbines will use in a normal year.
The queue is not a rumor, so the ratepayer argument has a real base. A load that never shows up on ERCOT’s books cannot be socialized through a Texas wires charge in the years it stays islanded. The unfinished part is the second sentence Amazon already wrote. A plant built to interconnect is a plant that will, on some future docket, look like any other large load, only with its own turbines already on the pad.
A 15-Mile Pipe Ties the Campus to Waha
Pacifico markets GW Ranch as more than a simple-cycle field. The January announcement described the largest permit granted in the United States and a stack of gas, storage, and solar on more than 8,000 build-ready acres.
WHAT PACIFICO SAYS IS ON THE PAD
- Gas nameplate: Up to 7.65 gigawatts from a mix of small and large-scale turbines, 35 units in the permit filings.
- Delivered target: More than 5 gigawatts by 2031, with first power in the first quarter of 2027 and 1 gigawatt online in 2028.
- Storage and solar: 1.8 gigawatts of batteries and up to 750 megawatts of solar on the same private grid.
- Fuel: Several laterals, including a 15-mile pipe rated at 1 billion cubic feet a day into the Waha hub.
- Jobs claim: More than 1,000 construction jobs, plus hundreds of permanent posts, with an endorsement from Pecos County leadership.
The 7.65 gigawatt figure is the permitted envelope. The commercial promise is the lower 5 gigawatt path. Anyone quoting only the larger number is reading the air file, not the build plan. Anyone quoting only the smaller number is leaving the extra turbines in the drawer.
Waha is the point. Associated gas in the Permian has to go somewhere, and a dedicated lateral turns a West Texas location into a fuel contract instead of a transmission study. Pacifico’s page lists five-nines availability as the product hyperscalers are buying. Speed is the other product. Grid studies do not deliver first power in the first quarter of 2027.
Wardlaw Tells Austin the 765-Kilovolt Lines Can Wait
At the Public Utility Commission of Texas open meeting on Aug. 14, 2026, Val Verde County Commissioner Kerr Wardlaw told commissioners that Amazon’s Pecos gas plant cancels the case for 765-kilovolt lines. He asked the commission to pause, matching a request state lawmakers had already made that morning. Amazon had said a week earlier that it still plans to connect when the queue allows.
That is the second-order fight hiding under the family-bill sentence. If enough AI load builds its own plants in the Permian, the public case for new extra-high-voltage lines into West Texas gets thinner in county halls even as the state still needs those lines for oilfield load and for the day the campuses do interconnect. Off-grid generation can protect a residential tariff this year and still scramble transmission politics for a decade.
Cleanview’s tally of the copycat wave is the backdrop. Data-center developers have announced nearly 60 behind-the-meter gas projects since the start of 2025, with a combined 90 GW of capacity. The firm is careful to say not all of them will be built. A growing share, it found, have broken ground or signed tenant deals. In June 2026, Microsoft said it would put a data-center campus near Pecos on 2 gigawatts of off-grid gas with Chevron, about 30 miles west of GW Ranch. Google and Meta have their own gas files. Amazon’s Pecos deal is the first time it has made a major off-grid bet of this kind. Until this year, it had run its halls on grid power.
On a July 30, 2026, investor call, chief executive Andy Jassy said AWS had just posted its fastest growth in 18 quarters, driven by AI, and that demand for compute still ran ahead of the company’s data-center supply. The mismatch, he said, would last well into the following year. A private plant next to the halls is how that gap gets closed without waiting on ERCOT.
If the models get cheaper to run, or if the next training cycle needs fewer watts than the last, the turbines do not move to a residential feeder. The credit sits with Pacifico and whoever financed the iron. That is the quiet trade inside the ratepayer pitch. Texas families are off the note while the island holds. The developer is on it for the life of the debt.
Homer City Repeats the Off-Grid Gas Template
Amazon already said Pecos is not a one-off. In August 2026, a spokesman said the company was in talks with Homer City Redevelopment in Indiana County, Pennsylvania, as part of a pledge to invest at least $20 billion in the state, and that no definitive agreement was in place. The site is a former coal station being rebuilt around about 4.5 gigawatts of new gas. By late September, local permit filings described a 36-building Amazon campus on that pad.
Homer City’s developers once billed their plant as the largest gas project in the country. Pecos took that title on paper, then turned it into a type. The pattern is the same in both places: put the turbines next to the halls, sell the isolation as a gift to everyone else on the system, and leave a door open to the grid.
Pacifico still lists first power at GW Ranch in the first quarter of 2027. The TCEQ permit runs to Jan. 21, 2036. What happens between those dates, on the ERCOT side of the fence, is the part Amazon has not had to file yet.
-
